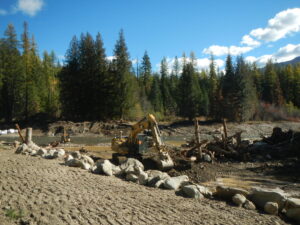

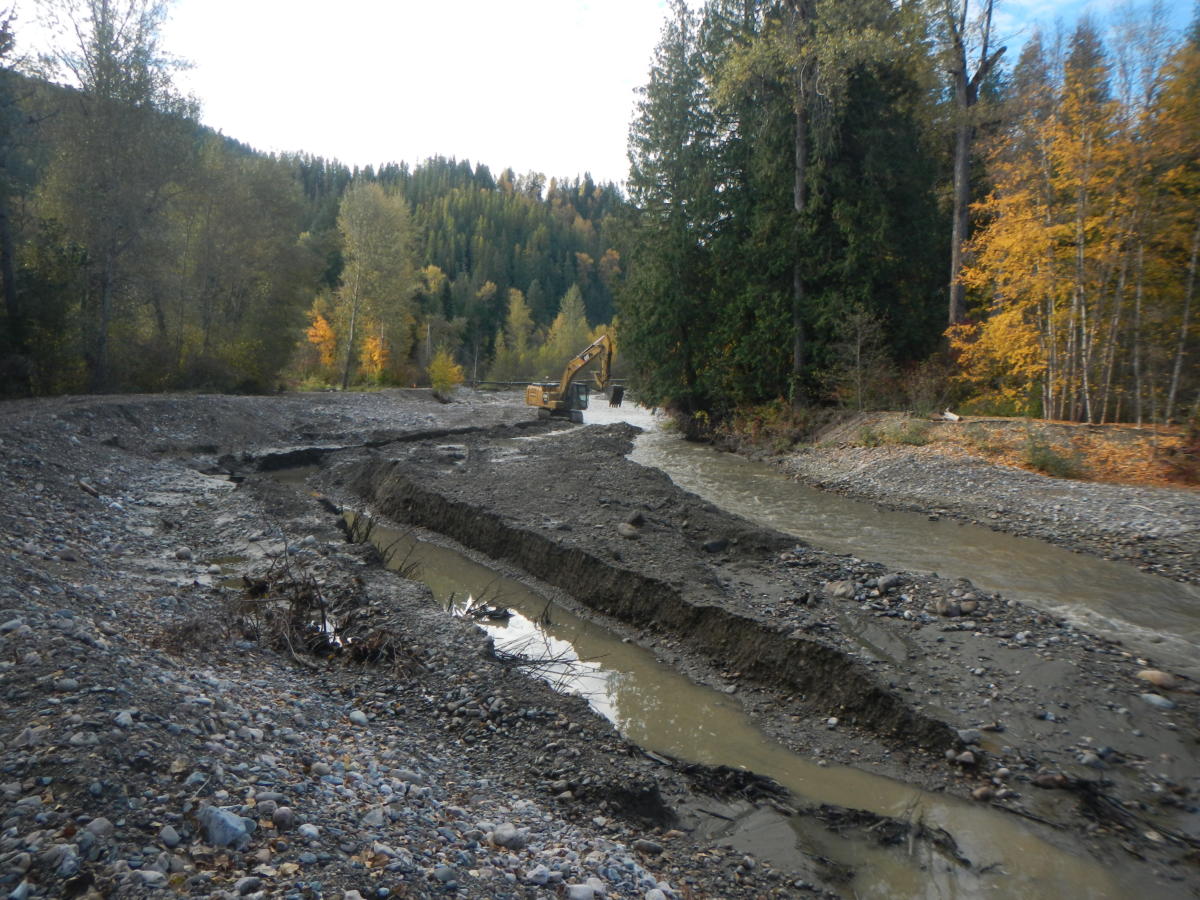

Work was completed placing rootwad logs in the overflow channel at RM 3.0. Trail work continues on the south side trail with a road having been constructed to access the western portion of the trail. Work continued on the lowland trail, grading and placing crushed rock over geotextile fabric. Logs continued to be placed throughout the site in high density planting areas. Remaining ELJs continue to be constructed. Materials for helicopter placed ELJs were staged at a designated landing area. Limited duration releases from Sullivan Lake continued intermittently thought the week. All completed areas were harrow raked (where appropriate) and seeded. Live stakes continued to be delivered and planted at the southern portions of the site. The upper reach continued to be graded with material placed as fill on the campground erosion structures. The campground bridge abutment was excavated and boulders began to be placed. Starter channels were excavated at the Metaline Falls sewer lagoons to motivate impounded sediments.
